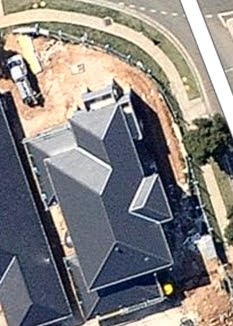

Wednesday, September 29, 2010
Saturday, September 25, 2010
Balcony rails
Saturday, September 18, 2010
Garage Door
and more gyprock
More internal shots
Gyprock - Internal pics
Friday, September 17, 2010
Stairs
Wow. A week of activity this week with the staircase arriving as scheduled. We only have the through the window shots at present, but hopefully we'll get time to arrange another site visit soon to get some internal shots.
This weeks has also seen the garage door arrive, the front door, the upstairs door to the balcony, and the laundry door. Also, the anchor parts for the balcony rail have been fitted. It's hard to see, but I think some of the cornices have been done.
If the rest of the build progresses at the speed of this week, then we might have a decent chance of an on time finish.
Oh and I wanted to thank everyone for the comments on the blog. For some reason I can't figure out how to respond to them, but we appreciate your comments. Thanks
Friday, September 10, 2010
Gyprock
Friday, September 3, 2010
An update about not a lot
Things have really slowed down these last few weeks. We've seen virtually no progress for at last a couple of weeks now. The only change I could see was that the wall and roof insulation has been installed, probably half a day's work. There is still a fair way to go on the contract, but I'm beginning to have some reasonable concerns that the build is not going to come in on schedule. Gyprock was booked today, but at midday, there was no sign of anyone working.
We were the first to commence construction on our block, with the other 3 neighbours building with Beechwood, a private small building firm, and Clarendon. The Beechwood started a good 8 weeks after our build, and we are now the least progressed. The small building firm is winning the race, with all of their internal lining done. They are even up to landscaping and fencing. The Beechwood and Clarendon are about neck and neck, and we are coming dead last, wheezing our way to the finish line like a biggest looser contestant running a marathon. The best comparison to our build is the Clarendon, as it too is a 2 story, and they started just a week or so after us. The gyprock on the Clarendon is all done, and their staircase is in. Our staircase is booked to be started in about 2 weeks.
Hopefully next week we will see some gyprock.
We were the first to commence construction on our block, with the other 3 neighbours building with Beechwood, a private small building firm, and Clarendon. The Beechwood started a good 8 weeks after our build, and we are now the least progressed. The small building firm is winning the race, with all of their internal lining done. They are even up to landscaping and fencing. The Beechwood and Clarendon are about neck and neck, and we are coming dead last, wheezing our way to the finish line like a biggest looser contestant running a marathon. The best comparison to our build is the Clarendon, as it too is a 2 story, and they started just a week or so after us. The gyprock on the Clarendon is all done, and their staircase is in. Our staircase is booked to be started in about 2 weeks.
Hopefully next week we will see some gyprock.
